Rock Scaling

Rock Scaling

Rock scaling is the controlled removal of loose, fractured, or detached rock from cut slopes, highway and rail corridors, mine highwalls, tunnel portals, and dam abutments to eliminate rockfall hazards at the source.

Immediate
Hazard Reduction
Any
Slope Angle
24/7
Emergency Response
15+
Years Experience
Overview

Understanding Rock Scaling

Rock scaling is the controlled removal of loose, fractured, or detached rock from cut slopes, highway and rail corridors, mine highwalls, tunnel portals, and dam abutments. It sits at the top of the rockfall mitigation hierarchy: scaling eliminates the source mass, while rock bolting reinforces rock that must remain in place and draped mesh systems contain the debris released by future weathering. State DOTs prioritize scaling work through the FHWA Rockfall Hazard Rating System, and MSHA explicitly mandates scaling as a routine ground-control practice on every active mining bench through 30 CFR §57.3401. Scaling is also the prerequisite step for nearly every other rockfall mitigation system, since bolts, mesh, and shotcrete cannot bond reliably to material that is already loose.

What Is Rock Scaling?

Rock scaling is one of the oldest ground-control practices in civil and mining engineering. The core idea, strike the rock with a steel bar, listen for a hollow response, and pry away anything that rings hollow, predates highway construction by centuries and is still the field test that drives every modern scaling operation. The technique was codified for transportation use in 1990 when Pierson, Davis, and Van Vickle developed the Rockfall Hazard Rating System for the Oregon DOT and the Federal Highway Administration, giving engineers a structured framework to score rock cuts by failure likelihood, ditch effectiveness, climate, and traffic exposure, and to prioritize scaling expenditures across thousands of miles of highway corridor.

In mining, scaling is not optional. MSHA 30 CFR §57.3401 requires that loose ground "be taken down or supported before any other work or travel is permitted in or near the affected area," which makes scaling the first task of every shift on every working face. The cumulative result is that rock scaling is the most direct form of rockfall mitigation available to a slope owner: rather than reinforce, contain, or accept the hazard, the loose rock is simply removed.

Key Benefits

  • Immediately reduces rockfall hazard
  • Essential preparation for bolts, mesh, or netting
  • Can be performed in extremely steep terrain
  • Low-impact and fast to deploy
  • Provides rapid safety improvements

Used In Our Services

The Engineering

How Rock Scaling Works

How the system carries load in service, and how we build it on site.

Construction follows a three-stage sequence: hazard identification, access setup, and progressive top-down removal. Identification combines visual mapping of joints, wedges, and overhangs with sounding, where a scaling bar struck against the rock returns a sharp ring on intact rock and a hollow drum-like response on detached or fractured blocks. Sounding remains the single most important field diagnostic in scaling work, since fractures hidden behind a few inches of competent surface rock cannot be seen from a rope position or from the ground.

Access is established through one of three methods or a combination. Rope-access teams certified to SPRAT or IRATA standards work vertical and overhanging faces from anchored rope systems. Long-reach excavators with hydraulic hammers, hydraulic thumbs, or scaling rakes work accessible cuts from the base or crest. Crane baskets handle high-reach work where rope anchors cannot be set safely overhead. Removal proceeds top-down because dislodged blocks travel downslope under gravity, and a bottom-up sequence would expose the crew below to falling material.

Tools scale with block size. Pry bars and pneumatic scaling hammers handle blocks up to a few hundred pounds. Inflatable airbags placed in joint apertures and pressurized to roughly 100 to 150 psi dislodge larger keyed blocks without explosives, which is the standard method on active highway corridors and near sensitive structures. Hydraulic splitters wedge into drilled holes to fracture massive blocks into pieces that can then be controlled and lowered. Light trim or buffer blasting is reserved for overhangs and bulk reshaping that exceed mechanical methods, and is typically planned as a separate controlled blasting phase rather than mixed into hand scaling work.

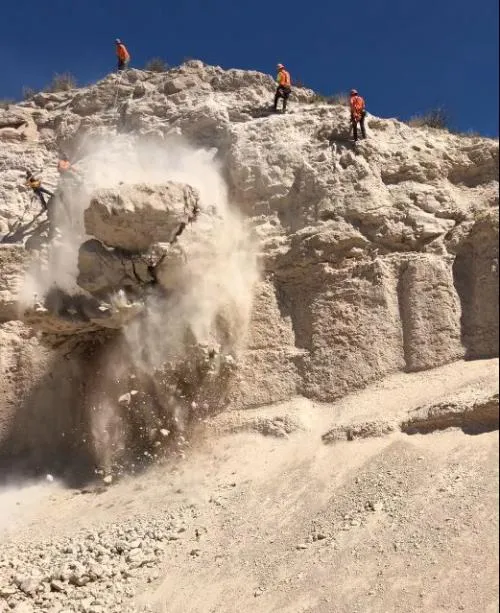

1

Slope Assessment

Identify loose blocks, wedges, and overhangs through visual inspection and sounding.

2

Access Setup

Establish rope systems, crane baskets, or mechanical access to work areas.

3

Material Removal

Remove unstable material using pry bars, pneumatic tools, airbags, or hydraulic methods.

4

Cleanup & Verification

Clear debris from catchment areas and verify slope stability before demobilization.

System Variants

Types of Rock Scaling

Type 01

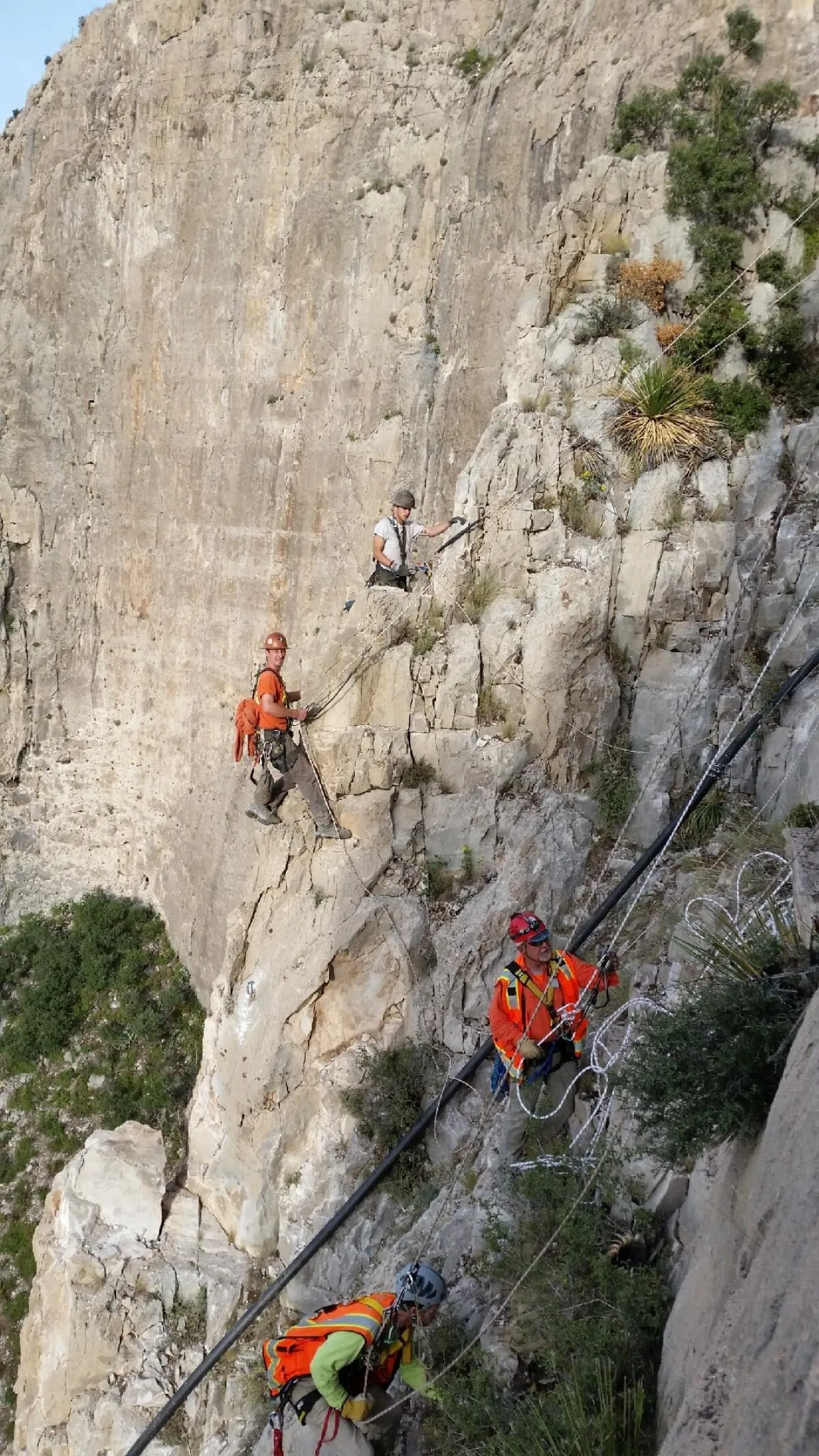

Manual Hand Scaling

Manual scaling is the rope-access standard for vertical and overhanging faces, selective removal near roadways, and any work where mechanical access cannot be safely established. A two-person team typically descends from anchored rope systems with pry bars, pneumatic scaling hammers fed by a compressor on the slope crest, and tag lines for controlling dislodged blocks. The method is precise: an experienced scaler sounds the face systematically, marks loose blocks for removal, and leaves intact rock undisturbed. Production rate is lower than mechanical methods but the technique works on any slope geometry that ropes can reach, which is effectively unlimited.

Type 02

Mechanical Scaling

Mechanical scaling uses an excavator equipped with a hydraulic hammer, hydraulic thumb, or scaling rake to remove loose rock from accessible cut slopes. A standard tracked excavator scales any face the operator can reach from the base or crest of the cut, with high-reach long-front excavators extending the working radius to 60 feet and beyond. The method is the standard tool for production scaling on highway widening, post-blast muck removal, and quarry highwall maintenance, since a single machine can move volumes of loose material that a rope team would take weeks to clear. Mechanical scaling is generally combined with a follow-up rope-access pass to handle the upper face and the locations the machine cannot reach.

Type 03

Airbag and Hydraulic-Splitter Scaling

Airbag scaling uses inflatable steel-reinforced bladders placed in joint apertures and pressurized to roughly 100 to 150 psi to dislodge large keyed blocks where blasting is restricted. The method is the workhorse for active corridors, tunnel portals, and abutments adjacent to operating infrastructure, where vibration and flyrock from controlled blasting are unacceptable. Hydraulic splitters extend the same idea to massive blocks: a feathered hole is drilled into the block, the splitter is inserted, and hydraulic pressure wedges the block apart along a controlled fracture plane. Both methods give the operator far tighter control over the timing and direction of release than blasting can, at meaningfully higher cost per cubic yard than either hand or mechanical scaling.

Type 04

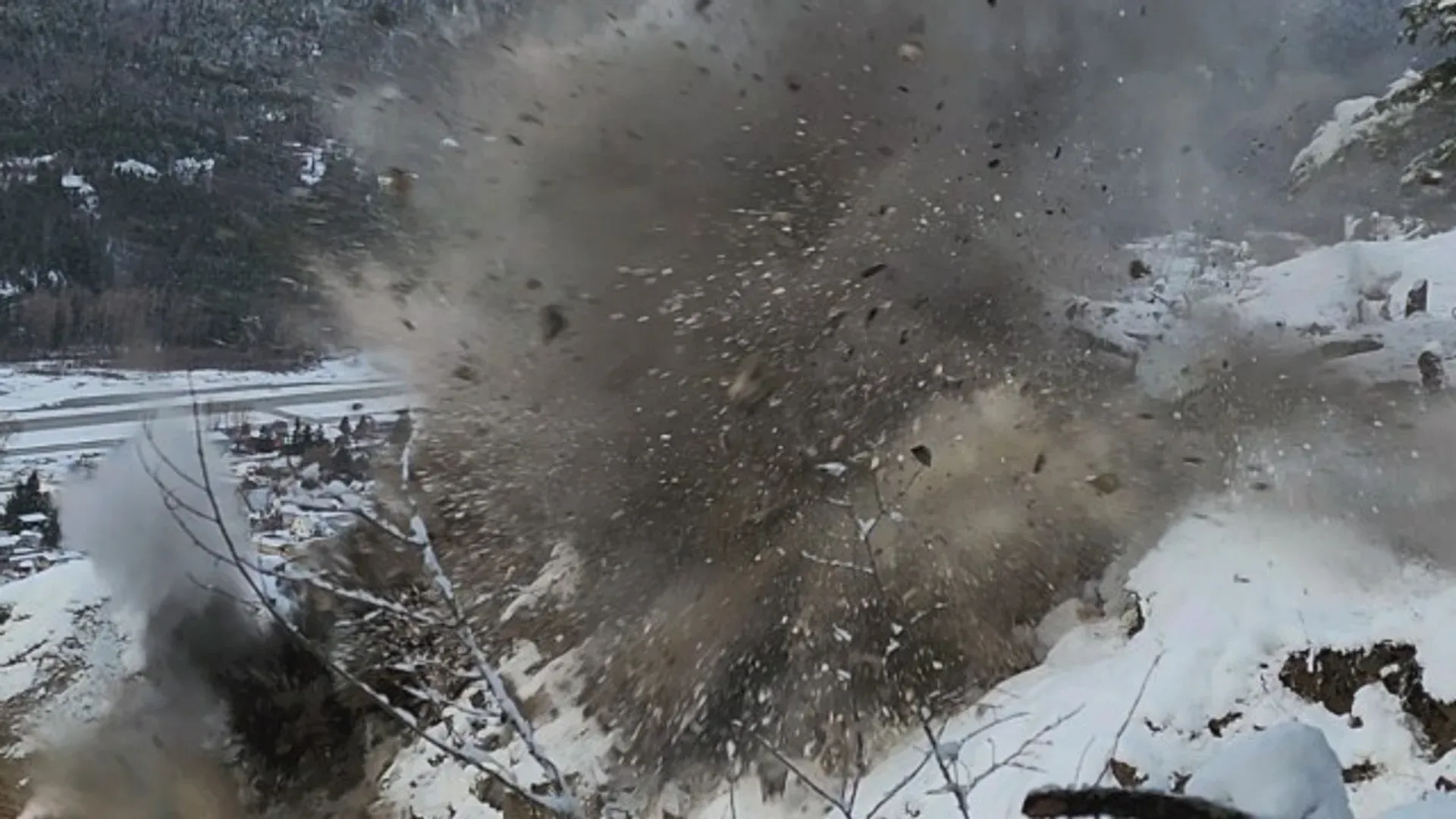

Trim and Buffer Blasting

Trim blasting (also called buffer or smooth-wall blasting) uses light, closely-spaced explosive charges to scale overhangs and reshape rock faces that exceed mechanical methods. The technique is distinct from production blasting in that the charges are sized to fracture the immediate face without disturbing the rock mass behind it, leaving a clean engineered slope ready for subsequent stabilization. Trim blasting is typically planned and permitted as a separate operation on highway and rail projects, with vibration and flyrock controls coordinated against the surrounding infrastructure. It is often the only practical scaling method for very large overhanging masses that would defeat airbags and splitters.

Side By Side

Rock Scaling vs Other Rockfall Mitigation Approaches

VS

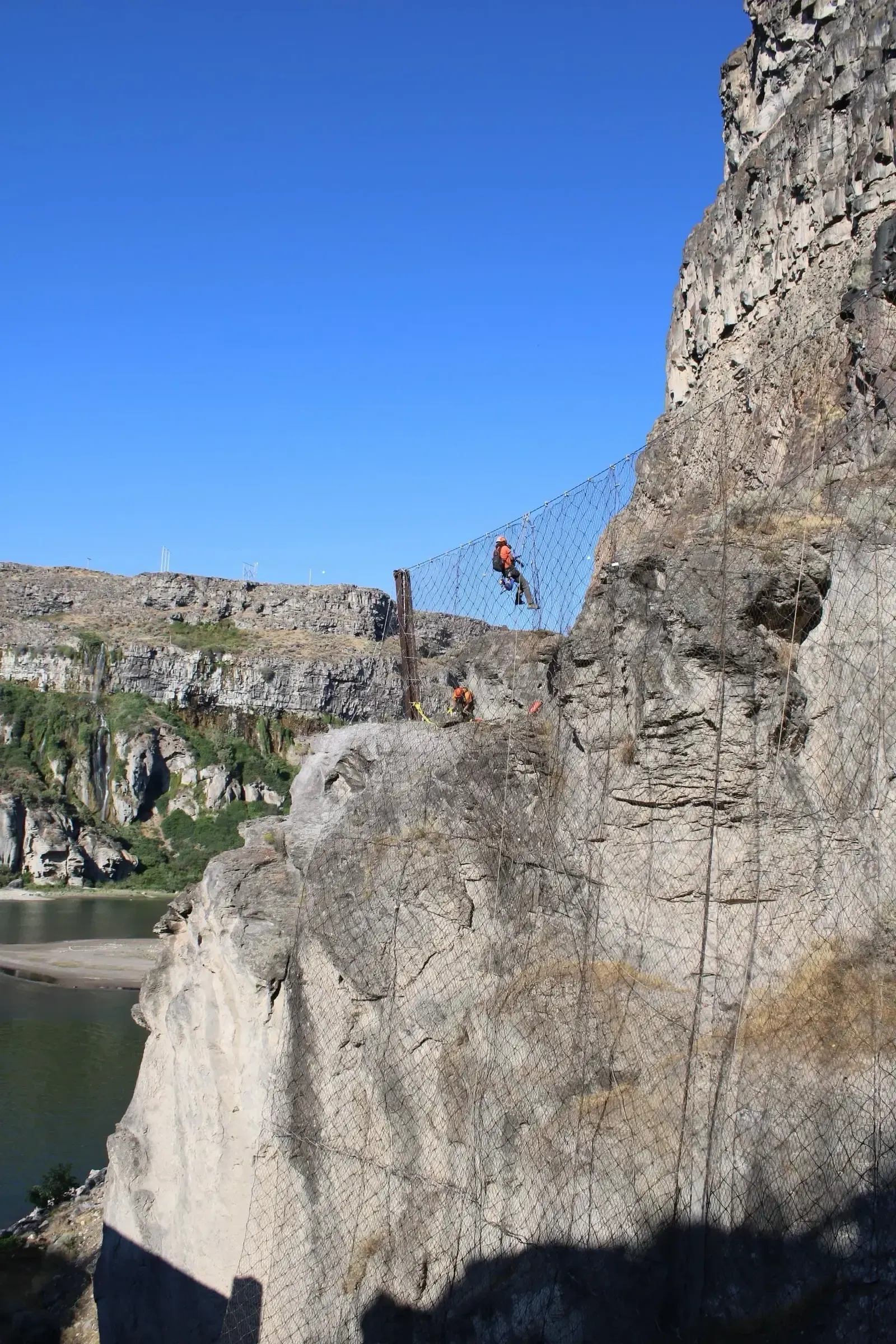

Rock Scaling vs Draped Mesh

The fundamental distinction is source removal versus debris containment. Scaling eliminates the rockfall by physically removing the loose mass, while a draped mesh system accepts that future rockfall will occur and uses a steel-cable or wire-mesh blanket hung from the slope crest to guide released debris down the face into a catchment ditch at the toe. Most DOT and rail corridors use both methods in sequence: scaling crews reduce the immediate hazard by clearing loose surface material, then a draped mesh system manages the ongoing release of weathered, freeze-thawed, or seismically-loosened rock over the design life of the slope. Scaling is one-time corrective work; mesh is permanent passive protection.

VS

Rock Scaling vs Rock Bolting

Scaling removes unstable rock; rock bolting anchors unstable rock in place. The selection follows block size and what the block is supporting. Small loose blocks that contribute nothing structural to the slope are cheaper to scale than to bolt, since each bolt installation requires drilling, tensioning, and grouting where a single scaling pass clears the same hazard in minutes. Large keyed blocks that support overlying mass cannot be scaled without collapsing the slope above them, so they must be bolted, with the bolts engineered to develop tension across the joint and pin the block to the competent rock behind it. A typical slope mitigation program scales the loose surface material first, then bolts the structurally critical blocks that scaling exposed.

VS

Rock Scaling vs Controlled Blasting

The defining difference is selective versus bulk treatment. Scaling targets individual loose blocks identified through sounding and visual mapping; controlled blasting reshapes the rock face wholesale through engineered explosive charges. The two methods coexist on most cut-slope projects. A new highway alignment is typically opened with production blasting that drops the bulk of the cut, followed by scaling crews who clean up the blast muck and remove loosened rock left behind on the new face. Trim blasting, the lightest blasting category, blurs the boundary by using small charges to remove overhangs that mechanical scaling cannot reach. Owners selecting between the two should treat blasting as bulk reshaping and scaling as the hazard-reduction follow-up.

Not sure which system fits? We'll walk through the tradeoffs for your site conditions.

Talk Through Your Options
Where It Fits

Common Applications and Project Types

State DOT highway and interstate cut slopes are the dominant volume driver for rock scaling work, with the FHWA Rockfall Hazard Rating System providing the framework state engineers use to prioritize which slopes get scaled in any given fiscal year. Class I freight railroads operate parallel internal hazard rating programs and contract scaling work across mountainous corridors and through tunnel approaches. Mining highwall scaling is mandated on every active bench by MSHA 30 CFR §57.3401, which makes scaling crews a routine fixture on metal, non-metal, and aggregate operations.

Beyond corridor and mining work, scaling appears on tunnel portals as the first step before structural shotcrete or rock-bolt installation, on dam abutments and spillways during periodic safety inspections, on post-fire slopes where heat-fractured rock has created a step-change in rockfall potential, and as immediate emergency response after an active rockfall event. The technique is also a standard prerequisite for nearly every other rockfall mitigation system, since bolts, mesh, and shotcrete cannot bond reliably to material that is already loose, so a rock scaling contractor is typically mobilized before the rest of the mitigation crew arrives on site.

Highways and rail corridors beneath steep rock slopes
Tunnel portals and cut faces
Mining highwalls
Slopes experiencing frequent rockfall
Preparation for mesh, bolts, or shotcrete
Emergency rockfall response
Benefits

Key Advantages

Immediate Hazard Reduction

Scaling removes the source of rockfall hazards rather than just containing debris, the most direct form of mitigation.

Rope-Access Capability

Trained crews access vertical and overhanging faces where equipment cannot reach.

Prepares for Other Treatments

Scaling clears loose material before mesh, bolting, or shotcrete installation for optimal system performance.

Rapid Deployment

Scaling crews mobilize quickly for emergency response after rockfall events.

Cost-Effective

Often the most economical first step in a rockfall mitigation program.

Engineering

Technical Considerations

Soil/Rock Conditions

Rock type and fracture patterns determine scaling methods. Highly fractured rock may require extensive scaling; massive rock may have isolated loose blocks.

Groundwater

Seepage can indicate loose zones. Freeze-thaw cycles loosen rock seasonally, often requiring periodic re-scaling.

Load Capacity

Not applicable, scaling removes material rather than supporting it.

Spacing

Not applicable, coverage determined by hazard assessment.

Installation Method

Crews work systematically across the face, sounding rock and removing loose material. Large blocks may require rigging for controlled lowering.

Equipment Used

  • Rope-access rigging systems
  • Pry bars and scaling tools
  • Pneumatic hammers and splitters
  • Airbags for block dislodgement
  • Crane baskets for high-reach access

Limitations

  • Does not address deep-seated instability
  • May need periodic re-scaling
  • Large blocks may require blasting or splitting
  • Weather-dependent for rope access

Technical Specifications

Methods
Hand tools / Airbags / Hydraulic splitters
Access
Rope / Crane basket / Scaffold
Coverage
Unlimited face area
Material Handling
Controlled release / Rigging
Codes And References

Engineering Standards and References

FHWA

FHWA-OR-EG-90-01

Rockfall Hazard Rating System (Pierson, Davis, Van Vickle 1990)

The practitioner framework state DOTs use to score rock cut slopes by failure likelihood, ditch effectiveness, climate, and traffic exposure, and to prioritize scaling and rockfall mitigation expenditures across the highway network.

MSHA

30 CFR §57.3401

Examination and Scaling of Surfaces

The federal regulation requiring loose ground to be taken down or supported before any other work or travel is permitted in or near the affected area on metal and non-metal mining sites. The legal foundation for routine highwall scaling.

SPRAT / IRATA

Rope Access Standards

Society of Professional Rope Access Technicians / Industrial Rope Access Trade Association

The two industry certification bodies governing rope-access scaling crews. Crews on a permanent commercial slope scaling project should be certified to one or both standards, with documented technician levels for lead and supervisory positions.

Gallery

Our Work in Action

Expertise

Why Choose Rock Supremacy for Rock Scaling

Expert Rope-Access Crews

Trained technicians safely access vertical and overhanging faces.

Emergency Response

24/7 mobilization capability for urgent rockfall events threatening infrastructure.

Mechanical Capability

Excavators and high-reach equipment for production scaling on accessible slopes.

Integrated Solutions

Scaling combined with bolting, mesh, and barriers for end-to-end rockfall mitigation.

Safety Culture

Rigorous safety protocols on DOT, railroad, and mining projects, with rope-access crews trained to SPRAT or IRATA standards.

Questions

Rock Scaling FAQ

Rock scaling is the controlled removal of loose, fractured, or detached rock from cut slopes, highway and rail corridors, mine highwalls, tunnel portals, and dam abutments. The goal is to eliminate the source of potential rockfall by physically removing unstable blocks rather than reinforcing or containing them. Crews identify loose material by sounding the rock with a steel scaling bar (loose rock returns a hollow drum-like response) and remove it using pry bars, pneumatic hammers, airbags, hydraulic splitters, or excavator-mounted tools depending on block size and access. Scaling sits at the top of the rockfall mitigation hierarchy and is the prerequisite step for nearly every other rockfall system, since bolts, mesh, and shotcrete cannot bond to material that is already loose.
Crews sound the rock surface with a scaling bar: loose material produces a hollow drum-like response, while solid rock returns a sharp ring. Sounding is the single most important field diagnostic in scaling work because fractures hidden behind a few inches of competent surface rock cannot be seen from a rope position or from the ground. Visual inspection adds context, mapping joints, wedges, overhangs, weathered zones, and recent block separations. On larger projects the scaling assessment is structured against the FHWA Rockfall Hazard Rating System, which scores slope geometry, ditch effectiveness, climate, and traffic exposure to prioritize where scaling effort is spent.
Scaling removes unstable rock; rock bolting anchors unstable rock in place. The selection follows block size and what the block is supporting. Small loose blocks that contribute nothing structural to the slope are cheaper to scale than to bolt, since each bolt installation requires drilling, tensioning, and grouting where a scaling pass clears the same hazard in minutes. Large keyed blocks that support overlying rock mass cannot be scaled without collapsing the slope above them, so they must be bolted, with the bolts engineered to develop tension across the critical joint. A typical mitigation program scales the loose surface material first, then bolts the structurally critical blocks that scaling exposed.
Frequency depends on rock type, climate, and weathering rate. Slopes in massive granite or basalt may remain stable for years between scalings, while slopes in highly jointed sedimentary rock subject to freeze-thaw cycling or wet-dry weathering may require annual or even seasonal scaling. State DOTs typically schedule re-scaling on a multi-year cycle informed by the slope's RHRS score and recent rockfall activity. Mining operations re-scale every working bench at the start of each shift under MSHA 30 CFR §57.3401. Routine inspection by a qualified geologist or scaling supervisor is what determines when re-scaling is actually needed on any given slope.
Small material falls to catchment ditches or temporary collection areas at the slope toe for later cleanup. Large blocks are controlled with rigging, tag lines, or guided lowering systems to land in pre-designated zones away from infrastructure or active corridors. Debris is loaded out and either hauled off-site, used as embankment fill where geotechnically suitable, or stockpiled on the property for later use. Catchment ditch maintenance is part of standard scaling cleanup and is also a key variable in the FHWA Rockfall Hazard Rating System scoring.
Yes, with traffic control and method selection that match the corridor's exposure. On active highways the standard is to coordinate lane closures or full shoulder closures with the state DOT, position spotters and catch fences below the work zone, and use airbags or hydraulic splitters rather than blasting for large block removal so that flyrock and vibration are eliminated. On rail corridors crews coordinate work windows around train traffic, with track watchmen and slow orders as required by the railroad. Emergency scaling after an active rockfall event often runs around the clock under traffic control until the immediate hazard is cleared.
Rock scaling on transportation projects is structured against the FHWA Rockfall Hazard Rating System (Pierson, Davis, Van Vickle 1990, FHWA-OR-EG-90-01), which provides the framework state DOTs use to prioritize scaling expenditures. On metal and non-metal mining sites scaling is mandated by MSHA 30 CFR §57.3401, which requires loose ground to be taken down or supported before any other work or travel is permitted in the affected area. Rope-access scaling crews work to SPRAT (Society of Professional Rope Access Technicians) or IRATA (Industrial Rope Access Trade Association) certification standards, with documented technician levels for lead and supervisory positions. State DOT specifications typically reference these documents and add jurisdiction-specific safety, traffic-control, and environmental requirements.
The Rockfall Hazard Rating System (RHRS) is a structured scoring framework developed by Pierson, Davis, and Van Vickle in 1990 for the Oregon DOT and the Federal Highway Administration. It scores each rock cut slope on a set of weighted variables (slope height, ditch effectiveness, average vehicle risk, percent of decision sight distance, roadway width, geologic character, block size and quantity, climate and water on slope, and rockfall history) and produces a combined score that lets state engineers compare slopes across the highway network. The RHRS does not specify what mitigation to apply, but it is the framework state DOTs use to decide which slopes get scaling, mesh, barrier, or bolting funding in any given fiscal year. Most state DOTs maintain ongoing RHRS inventories of their rock cuts and update scores after each rockfall event.
Scaling addresses loose surface material. Deep-seated instability, large wedge or planar failure surfaces extending well behind the rock face, ongoing weathering that releases new material faster than scaling can remove it, or large structurally critical blocks that cannot be removed without collapsing the overlying slope all require structural mitigation rather than scaling alone. The standard responses are rock bolting or rock dowels for individual blocks, draped or pinned mesh for ongoing weathering release, structural shotcrete for surface stabilization, and rockfall barriers or attenuators for sites where source-level mitigation is not feasible. On most slopes the right answer is a combination, with scaling as the first step that exposes what the rest of the mitigation system needs to address.
Testimonials

Client Testimonials

Trusted by DOTs, engineering firms, and property owners nationwide.

Contact

Deploy Us

Ready to discuss your project? Our team is standing by to assess your site conditions and develop a custom solution using Rock Scaling and other proven techniques.

Emergency (24/7)

(541) 383-7625

Bidding & Estimates

Info@RockSupremacy.com

Headquarters

Western Division (HQ)
65147 N Hwy 97
Bend, OR 97701
Eastern Division
915 Millennium Ct
Blountville, TN 37617

Licensed in CO, UT, WY, ID, MT, CA, WA, OR, TN, VA

Request Consultation
